How a modular home gets on the ground
A modular home leaves the factory finished, but it still needs a licensed builder on site: approvals, footings, crane day, connections and sign-off. Here's what that involves, what it usually costs, and who does it.
Who does the install
The maker installs it
Many makers deliver, crane and connect their own homes, and some run the approvals too. Check what their price includes: some quote ex factory and add the site works later.
Makers that installA builder installs it
If your maker doesn't install, or doesn't install where you are, a licensed builder who installs homes from any maker runs the site side: approvals, footings, crane day, connections and sign-off.
Get install quotesBefore you buy a modular home
- Check the home is a house. A granny flat has to be built as a Class 1a dwelling. Many cabins, studios and imports aren't, and no builder can promise approval.
- Check the block first. Lot size, overlays, sewer, slope and crane access decide what fits, and what the site works cost.
- Compare the homes and makers. What each one costs installed, and what sits on top of the home price.
- Owner builder or licensed builder? On a modular install, owner builder can save money. Know what you take on.
- Read the quote line by line. The home is one number. Transport, crane, footings, connections and approvals are the rest.
- What it all costs in SEQ, start to finish.
Crane day, start to finish
- Site check: access, crane position, powerlines, slope
- Approval and footings: piers or slab, cured before the lift
- Crane day: truck in to module down, usually three to six hours
- Connected and signed off: plumbing, power, decks, stairs, final inspection
On the day

What's in an install

- Site check: access, crane position, powerlines, sewer and slope, before anything is booked

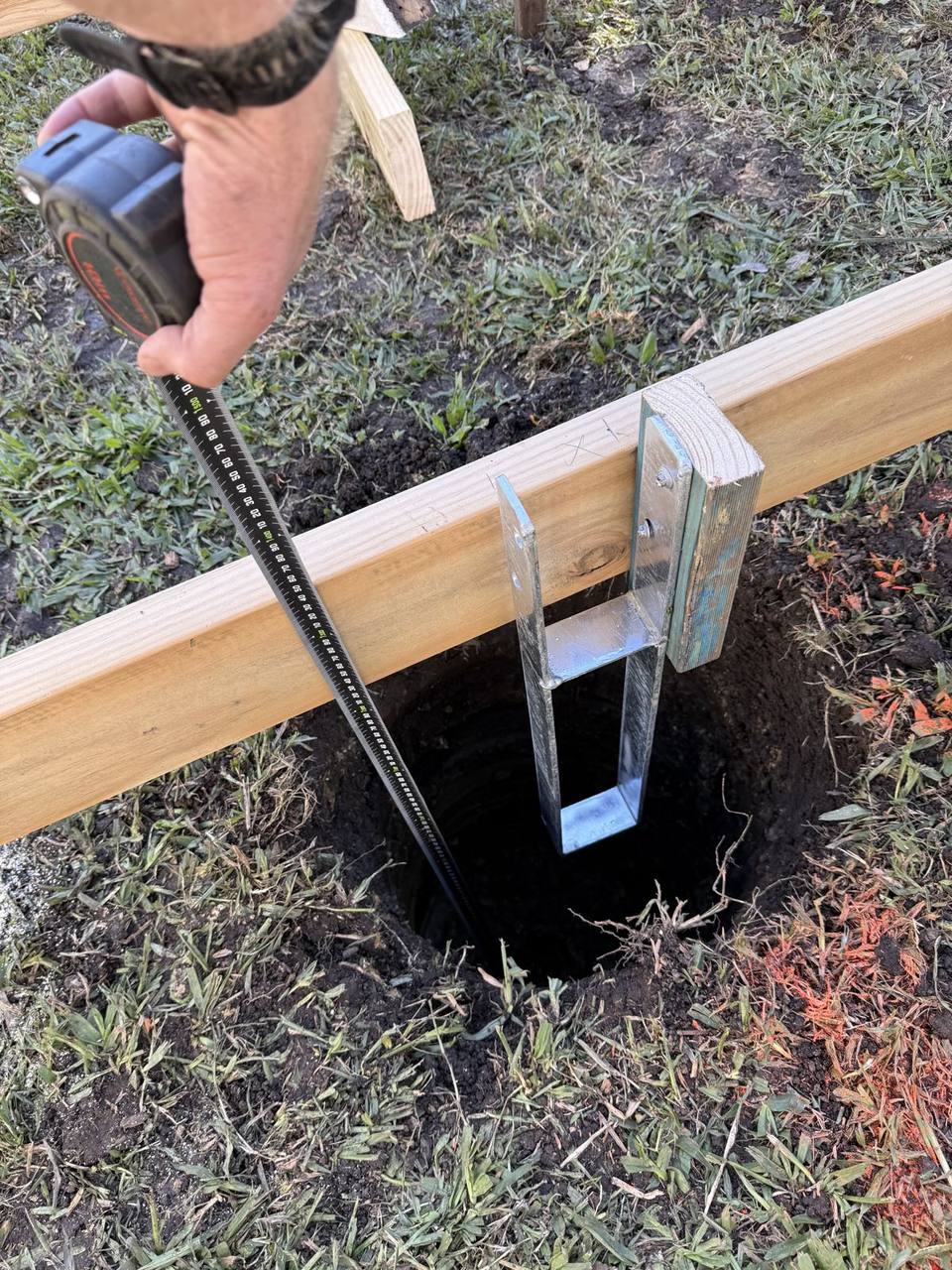

- Set-out by survey, and footings to the engineer's design: bored piers, screw piles or stumps
- Footing inspection, then cure time before the lift

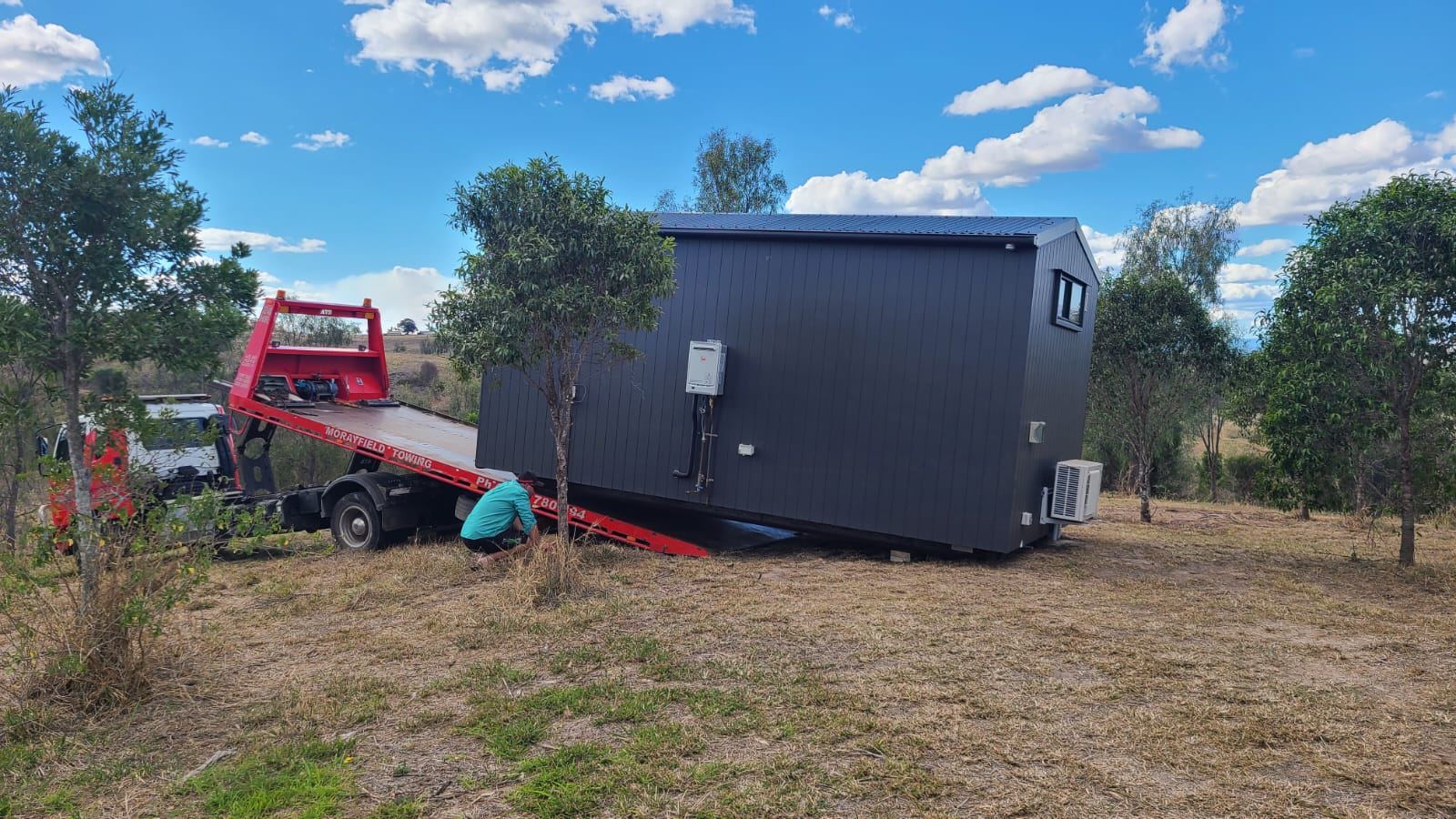

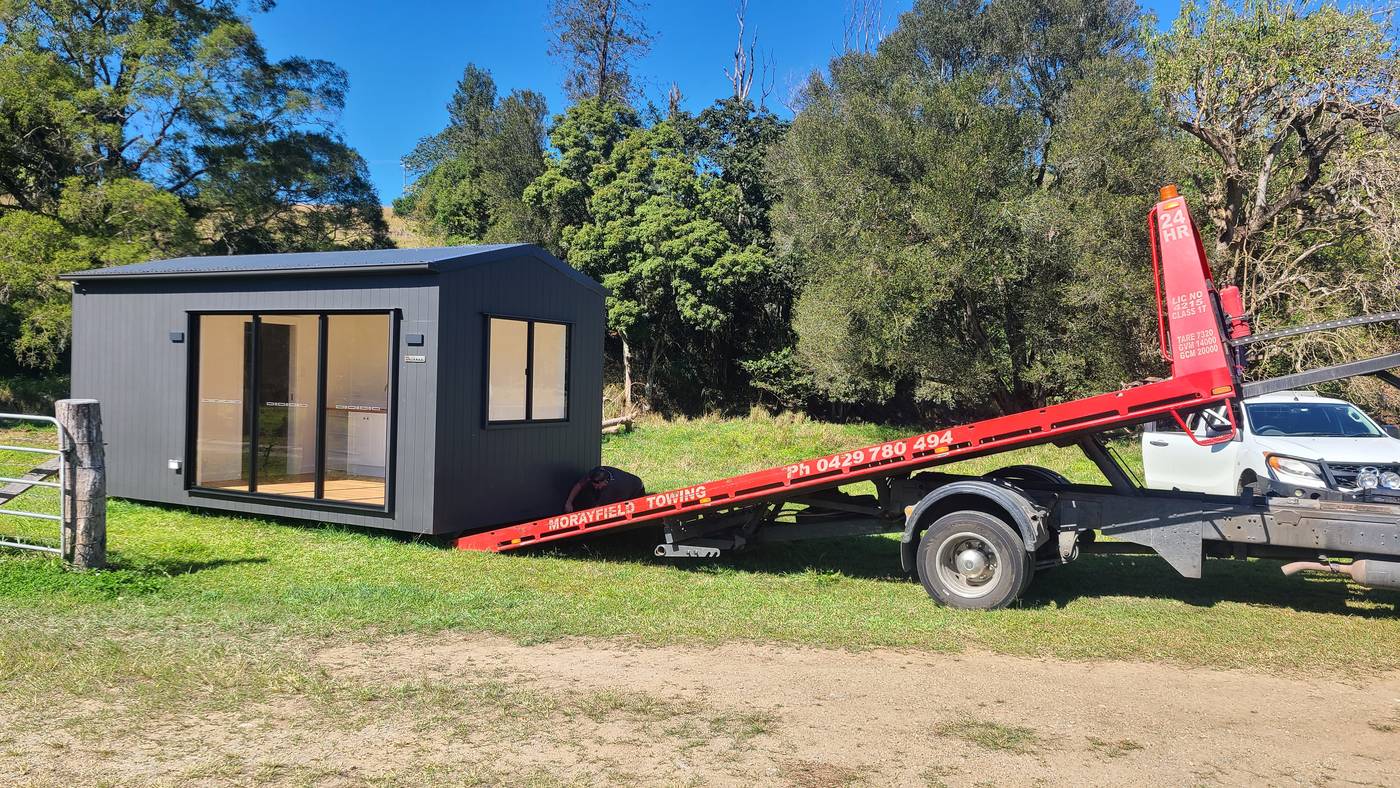

- Transport from the maker, crane booking and any traffic control
- Set-down, levelling and tie-down to the footings
- Joining and weatherproofing where a home comes in more than one module
- Water, sewer, stormwater and power connected by licensed trades
- Decks, stairs and balustrades if they're in the job
- Final inspection with the certifier, and the yard tidied
Usually not in it
- The home itself, which you buy from the maker
- Approvals, unless the installer has agreed to run them
- Mains or switchboard upgrades at the main house
- Landscaping, turf and driveways
Get every item priced in writing before you sign, so nothing turns up on crane day. Read how to read a building quote and owner builder or licensed builder before you compare.
$59,000 to $140,000, most of the time
Most installs in South East Queensland land between $59,000 and $140,000, inc GST, on top of the price of the home. The block decides where you land, not the home. These are the big buckets, from installer rates across the region.
| Bucket | Typical range, inc GST | What moves it |
|---|---|---|
| Certification and approvals | About $25,000 as an owner builder, about $35,000 with a licensed builder | Plans, soil test, engineering, certifier, council lodgement and plumbing approval. The licensed path adds home warranty insurance, the QLeave levy and the builder's margin, so it scales with the value of the home |
| Footings | $800 to $1,200 a pier or stump | Soil, slope and how many piers the engineer calls for. A typical small home sits on 6 to 14 |
| Delivery and crane | $8,000 to $38,000 | The biggest swing: distance, crane size, how far it has to reach, road closures and traffic control |
| Plumbing and drainage | About $16,000 | About $32,000 if the block needs an on-site wastewater system instead of sewer |
| Electrical | $5,000 to $9,000 | Run length from the switchboard, and whether the board or mains need an upgrade |
Outside those ranges, because the map decides them: bushfire and flood reports, a development application or town planner, survey, retaining on a slope, building over a sewer, and any extra inspections.
The $10,000 or so between the two certification numbers is the cost of a licensed builder standing behind a home someone else made. That's why owner builder on a modular install is worth a look. Get every line priced in writing before you sign.
Ready to install? The block needs
- A clear path at least 4.0 m wide
- 4.5 m overhead clearance, no low branches
- A firm, level spot for the crane
- Underground services marked
- Building approval issued
Before the truck turns up

Install questions
Who installs a modular home?
A licensed builder. Some makers install their own homes; others sell the home and leave the install to you. If yours doesn't install, a builder who installs homes from any maker does the approvals, footings, crane day, connections and sign-off. See who works where.
Who is the builder on an install?
Either the installer signs as the licensed builder, or you take out an owner builder permit and the installer works as your contractor. On a modular install owner builder is often cheaper, because a builder who signs for a home someone else made pays home warranty insurance on the whole job. The owner builder guide sets out what you give up.
How long does an install take?
Crane day itself is usually three to six hours, truck in to module down. With footings before and connections after, most installs take about six weeks on site once approval is in. If the home is already bought and approved, the whole job can be done in about three months.
What does the block need for crane day?
A clear path about 4 m wide, around 4.5 m of overhead clearance with no low branches or wires, a firm level spot for the crane, underground services marked, and the building approval issued. A good installer checks all of it before booking the crane.
What if a crane can't reach the spot?

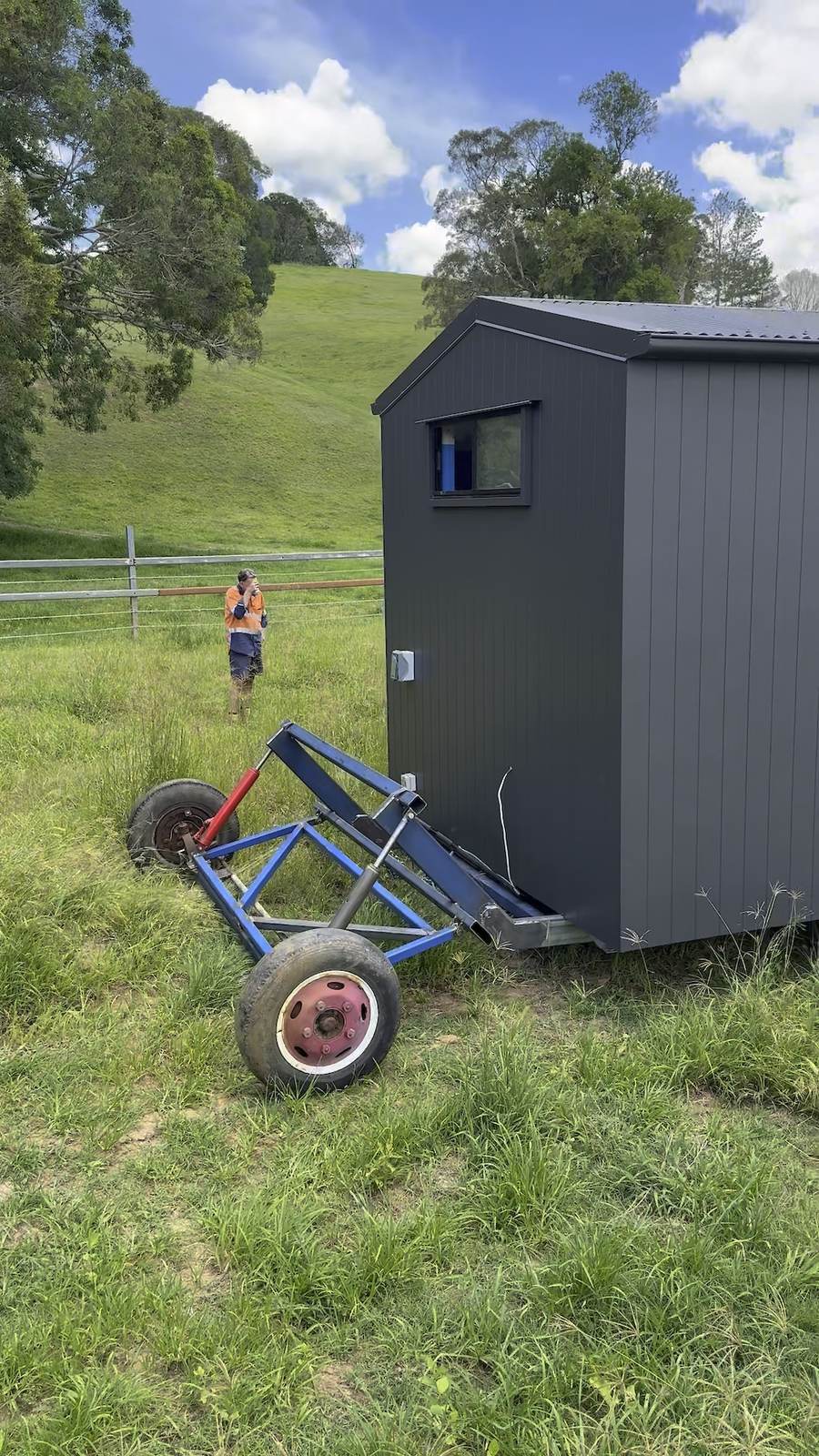

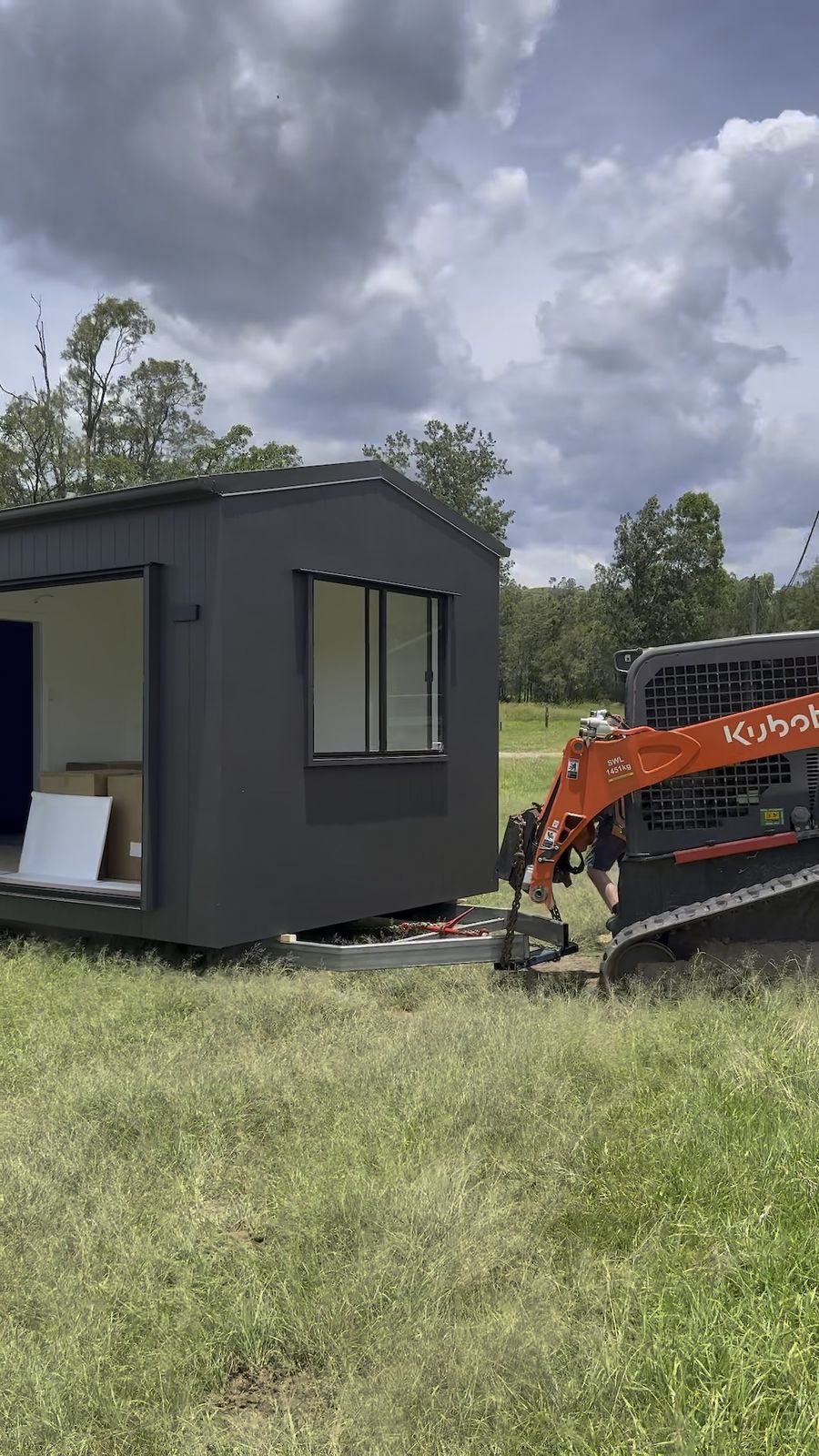

Sometimes a bigger crane from the street does it, sometimes a road closure, and on open rural blocks a dolly and a skid steer can move the module into place without a crane. It should be worked out at the site check, before you're committed.
Who connects water, sewer and power?
Licensed plumbers and electricians, organised by the installer. Power usually runs from the existing switchboard, which sometimes needs an upgrade first.
What does an install usually cost?
Most installs in South East Queensland cost between $59,000 and $140,000, inc GST, on top of the home. Certification and approvals run about $25,000 as an owner builder or about $35,000 with a licensed builder, footings $800 to $1,200 a pier, delivery and crane $8,000 to $38,000, plumbing about $16,000 and electrical $5,000 to $9,000. The free block check shows which end a block is likely to land.
